Passenger MTA says Penn Access project will take an additional three years to complete

MTA says Penn Access project will take an additional three years to complete

By David Lassen | October 27, 2025

Transit agency says issues push timeline to 2030, but has plan for some service by 2027

Email Newsletter

Get the newest photos, videos, stories, and more from Trains.com brands. Sign-up for email today!

Map showing location of new Metro-North stations in the Bronx
Four new Metro-North stations in the Bronx are part of the Penn Access project. With completion facing a three-year delay, the Metropolitan Transportation Authority is now proposing a temporary measure that would serve three of the stations. MTA

NEW YORK — Completion of the Metropolitan Transportation Authority’s Penn Access project, which will bring Metro-North trains to Penn Station and add four new stations in the Bronx, will likely be pushed back by three years to 2030 because of Amtrak’s failure to meet its obligations to the project, MTA executives said at a meeting of the MTA board’s Capital Program Committee today (Monday, Oct. 27).

However, the agency has a plan that would still provide limited service to three stations in 2027, the original target date, if Amtrak agrees to its proposals.

The Penn Access project involves rebuilding infrastructure and adding new tracks and stations along Amtrak’s Hell Gate line between Queens and New Rochelle. While the MTA is doing that construction work, it requires significant support from Amtrak. MTA CEO Janno Lieber recently voiced his unhappiness over a lack of that support, although Amtrak disputed his comments [see “MTA CEO blasts Amtrak …,” Trains.com, Oct. 6, 2025].

At today’s meeting, Jamie Torres-Springer, president of MTA Construction & Development, detailed problems involving windows, or outages, needed for work, and the Amtrak support personnel required to oversee that work, since the project is on Amtrak’s property.

“Amtrak was unable to provide outages,” Torres-Springer said. “You need outages to get work done, weekend outages, and I don’t think this is in dispute: … of the 48 outages committed to on paper in an agreement between Amtrak and the MTA, only seven were provided in the first two years.”

Later, he said, Amtrak provided more outages, but not the necessary staff: “Amtrak foremen didn’t show 98 days from March 2023 until August 2025. Without a foreman, you can’t take track out. You can’t work on the track.” There were also 77 days, he said, when electrical personnel were not on hand to shut off the catenary in work areas.

“So imagine night after night with outages,” Torres-Springer said, “which means that Amtrak has disrupted its own service, our contractor sending out its forces ready to work, and no one is there to allow them to work on track or work on power.”

Eventually, Torres-Springer said, both issues improved. “They have improved on their workforce supply considerably by doing a lot of hiring over the last few years,” he said. “I give them a lot of credit for that, but it hasn’t made much of a difference because of delays to date and because the arcane work rules and the bureaucracy have prevented us from making progress.”

Lieber told the board members the MTA was detailing the issues “so that that world understands what’s taking place.” He drew a comparison with the East Side Access project, which brought the Long Island Rail Road to a station beneath Grand Central Terminal years late and billions of dollars over budget. On that project, he said, MTA had problems with Amtrak at Harold Interlocking in Queens .

“I’m not blaming Amtrak for the entire East Side Access debacle,” Lieber said. “I got to drag it over the finish line when it was already 10 years old. [But] Amtrak’s problems, which are exactly the same type of problems we’re talking about here, had a significant impact. There was never really airing of it until very late in the game. What we’re trying to do is say, this is what happened and we need to find a route to deliver service before it starts to drag out like East Side Access.”

Temporary service plan

Illustraiton showing planned station for MTA Penn Access project

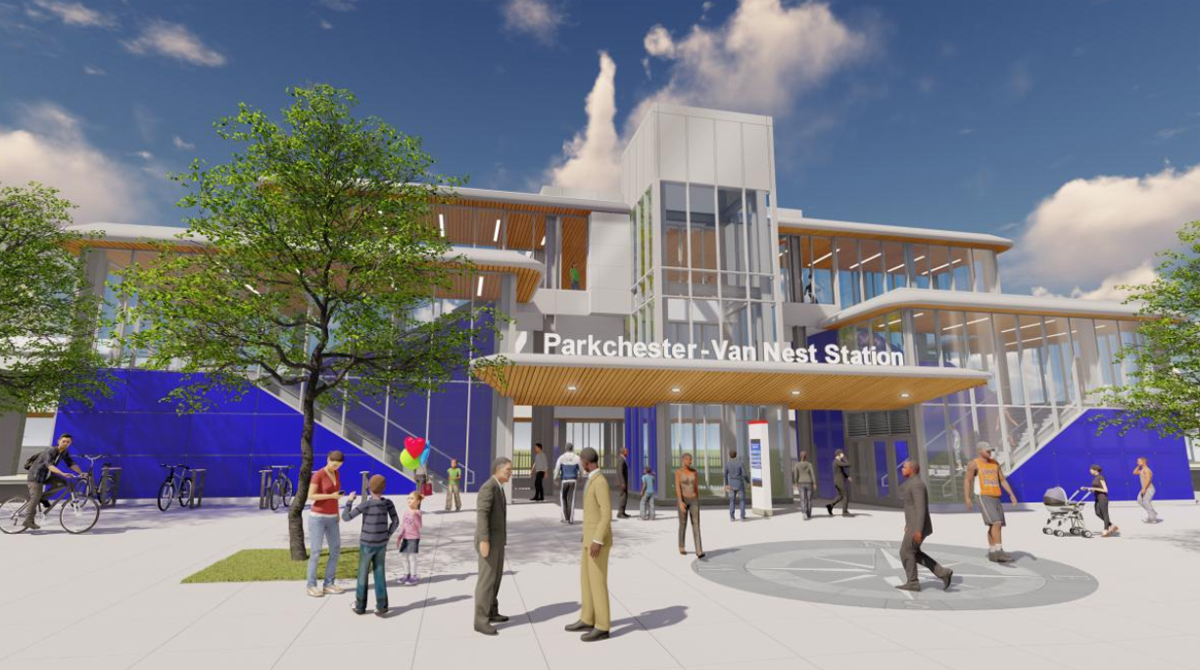

The Parkchester/Van Nest station in the Bronx should be completed by 2027, which would allow its use for a temporary version of Penn Access service proposed by Metro-North. MTA

At least initially, the MTA officials said that service could be provided with 31 trains a day serving the Parkchester/Van Nest station and temporary stations at the Co-Op City and Morris Park sites. (The fourth new Bronx station, at Hunts Point, will be in a location that can’t accommodate a temporary facility and still allow for construction, Torres-Springer said.) This would be done on the route’s existing two tracks, since the additional tracks the MTA plans to build — which would allow up to 105 Metro-North trains per day — will be delayed.

“Currently, Amtrak runs at most four trains an hour on the Hell Gate Line, two in either direction,” said Metro-North President Justin Vonashek. “What we’re proposing adds an additional three trains per hour in the peak periods and two per hour throughout most of the day. That brings the maximum total to seven trains per hour on a two-track railroad, a very reasonable number.”

Torres-Springer said that, in an effort to move the project along, the MTA is scaling back some of its planned construction, and has changed its operational plans. It now plans to use trainsets powered by the battery-electric locomotives the MTA has on order, rather than electric multiple-unit trainsets. “The battery locomotives mean that we don’t have to build third rail and two [electrical] substations,” he said.

However, that plan — like the effort to complete the entire project — will require agreements with Amtrak: to allow additional trains on its line in the short term, and on methods to speed up the project overall.

“No. 1 is cooperation to reach that 2030 date,” Torres-Springer said. “… It involves some fairly basic compromises: Letting us work on a larger portion of territory at a time. Find efficiencies in how the work is performed. Give us work rules that actually allow us to get work done. And since Amtrak forces are more comfortable putting up their own catenary power and signal lines, we’re happy for Amtrak to take over that work.”

An Amtrak spokesman told the news site The City that the company had taken moves including adjusting its schedule and suspending service to support the project, moves that Torres-Springer acknowledged. Spokesman Jason Abrams also said the MTA had not informed Amtrak about its analysis of the project.

“Amtrak has invested over $140 million and significant staff resources on the Penn Station Access project,” Abrams said in a statement reported by The City. “We remain committed to this critical project, and being good stewards of taxpayer investment for Amtrak, MTA customers, New York residents and travelers.”
